Stewart Road/8th Street White River Bridge

Location: Stewart Road at the White River

Project Completion: 2027

Description: This project will replace existing 2-lane bridge with a new 74-foot wide bridge with two unequal length spans. The new structure will accommodate 4 vehicle lanes, a sidewalk, and a trail crossing.

Benefits: The new bridge will alleviate the current bottleneck in the corridor to allow better traffic flow. The bridge will also support safe pedestrian movement across the bridge and connect to existing pedestrian facilities.

Existing Conditions Looking East Proposed Conditions Looking East

Map showing project area on Stewart Rd/8th Street over White River.

Location: Stewart Road at the White River

Project Completion: 2027

Description: This project will replace existing 2-lane bridge with a new 74-foot wide bridge with two unequal length spans. The new structure will accommodate 4 vehicle lanes, a sidewalk, and a trail crossing.

Benefits: The new bridge will alleviate the current bottleneck in the corridor to allow better traffic flow. The bridge will also support safe pedestrian movement across the bridge and connect to existing pedestrian facilities.

Existing Conditions Looking East Proposed Conditions Looking East

Map showing project area on Stewart Rd/8th Street over White River.

  • 12/05/2025 Construction Update

    • WORK COMPLETED FOR WEEK ENDING 12/06/2025:

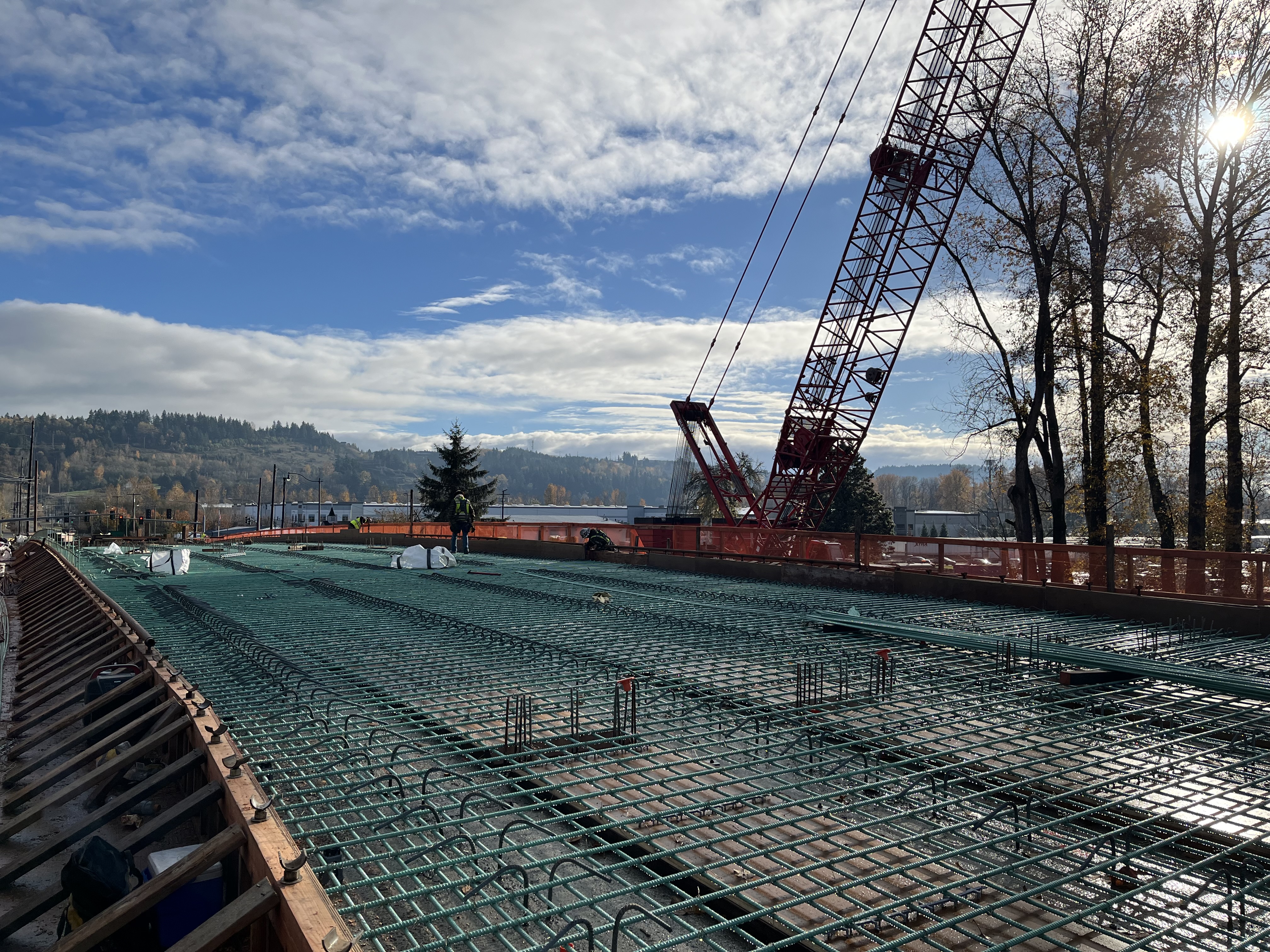

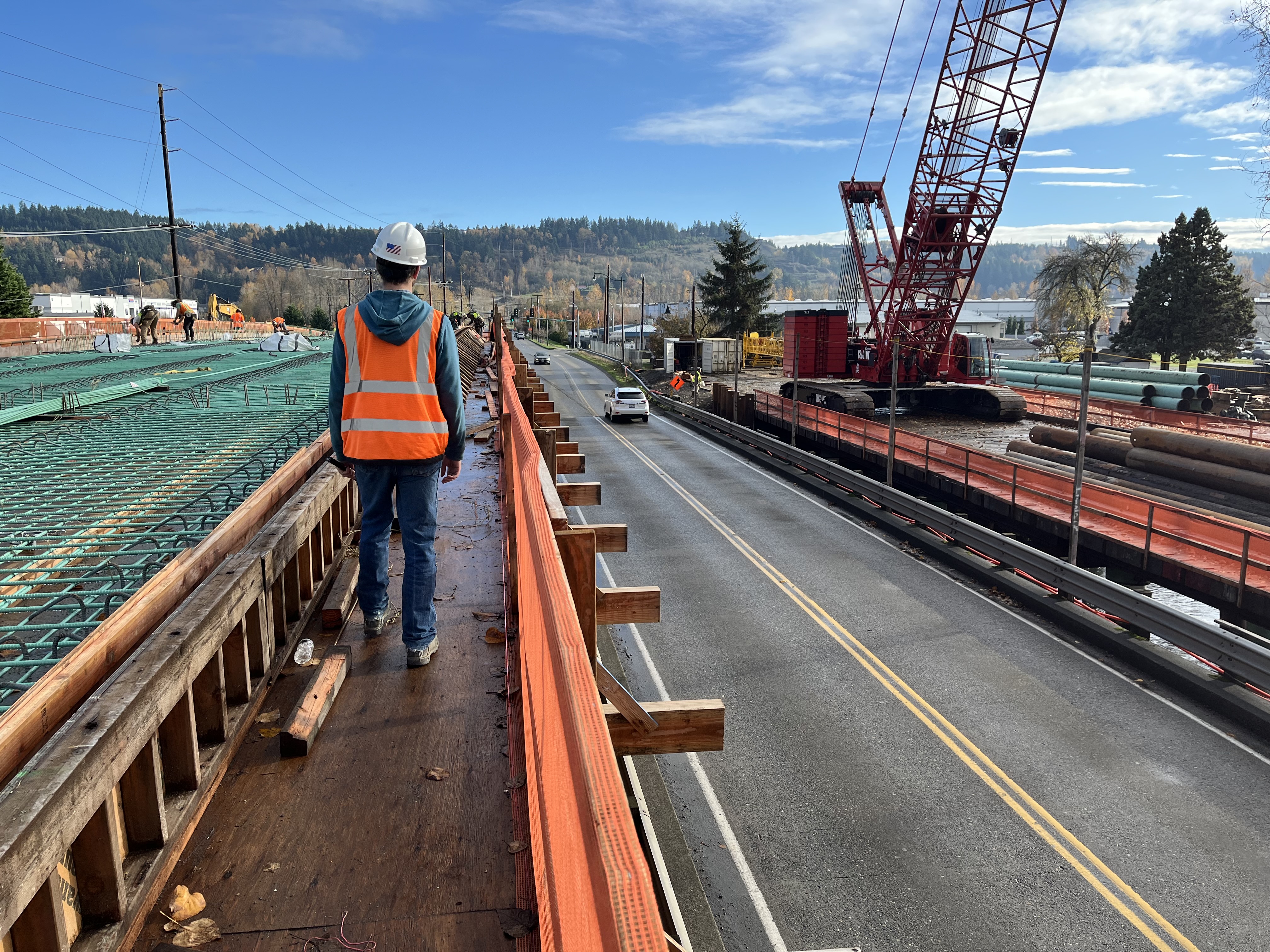

      • Continued work on bridge deck rebar installation
      • Continued work on bridge deck formwork
      • Continued surcharge settlement period
    • WORK IN PROGRESS NEXT WEEK (12/07/2025 - 12/13/2025):

      • Continue bridge deck rebar installation
      • Continued work on bridge deck formwork

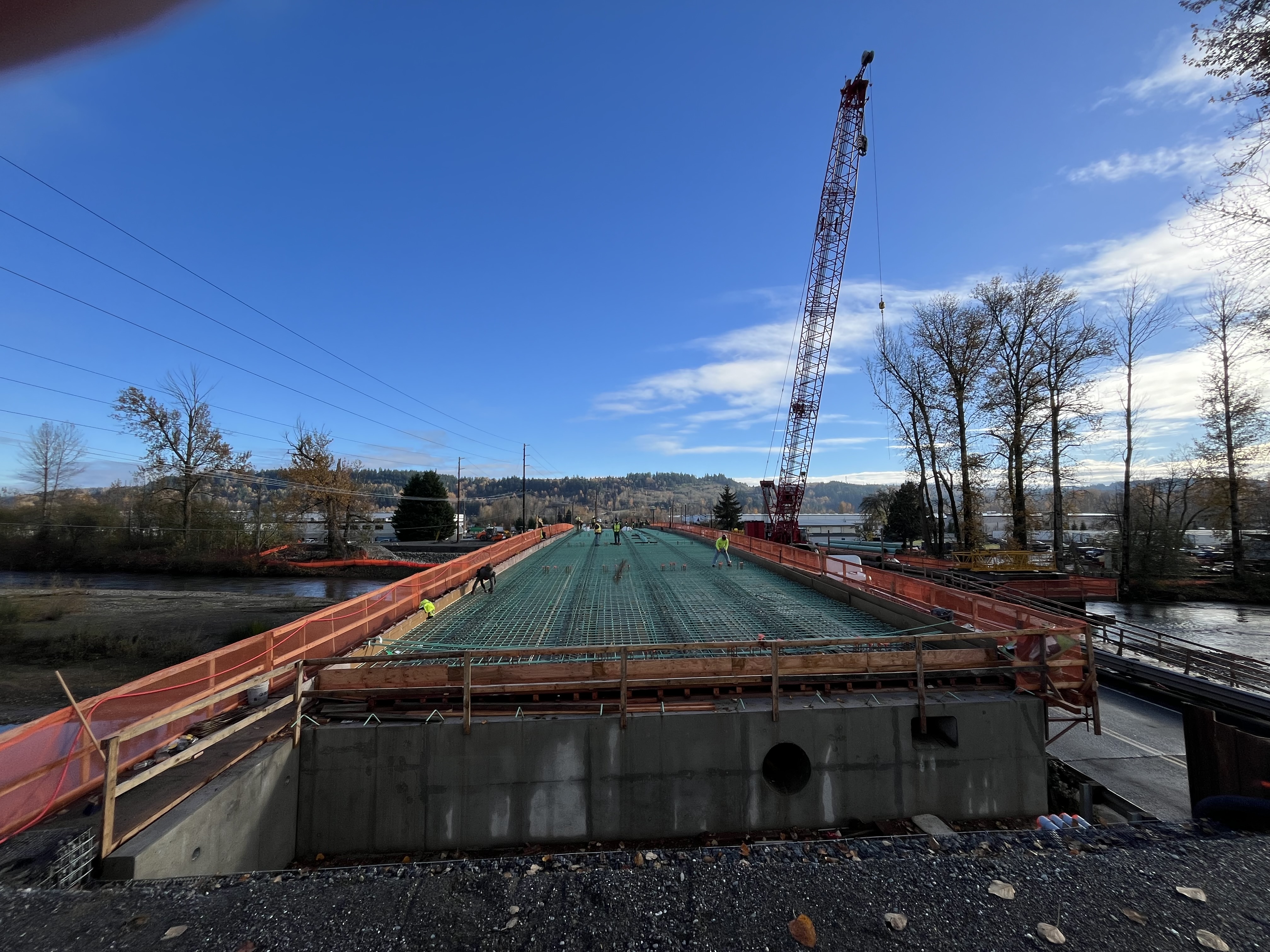

      • Pour concrete bridge deck
    • UPCOMING WORK THROUGH 12/30/2025:

      • Work will continue on new bridge substructure and bridge deck.
      • Surcharge settlement period will be 2 months
  • 11/21/2025 Construction Update

    • WORK COMPLETED FOR WEEK ENDING 11/22/2025:

      • Continued work on bridge deck rebar installation
      • Continued work on bridge deck formwork
      • Continued surcharge settlement period
    • WORK IN PROGRESS NEXT WEEK (11/23/2025 - 11/30/2025):

      • Continue bridge deck rebar installation
      • Continued work on bridge deck formwork
      • Pour concrete bridge deck
    • UPCOMING WORK THROUGH 11/30/2025:

      • Work will continue on new bridge substructure and bridge deck.
      • Surcharge settlement period will be 3 months

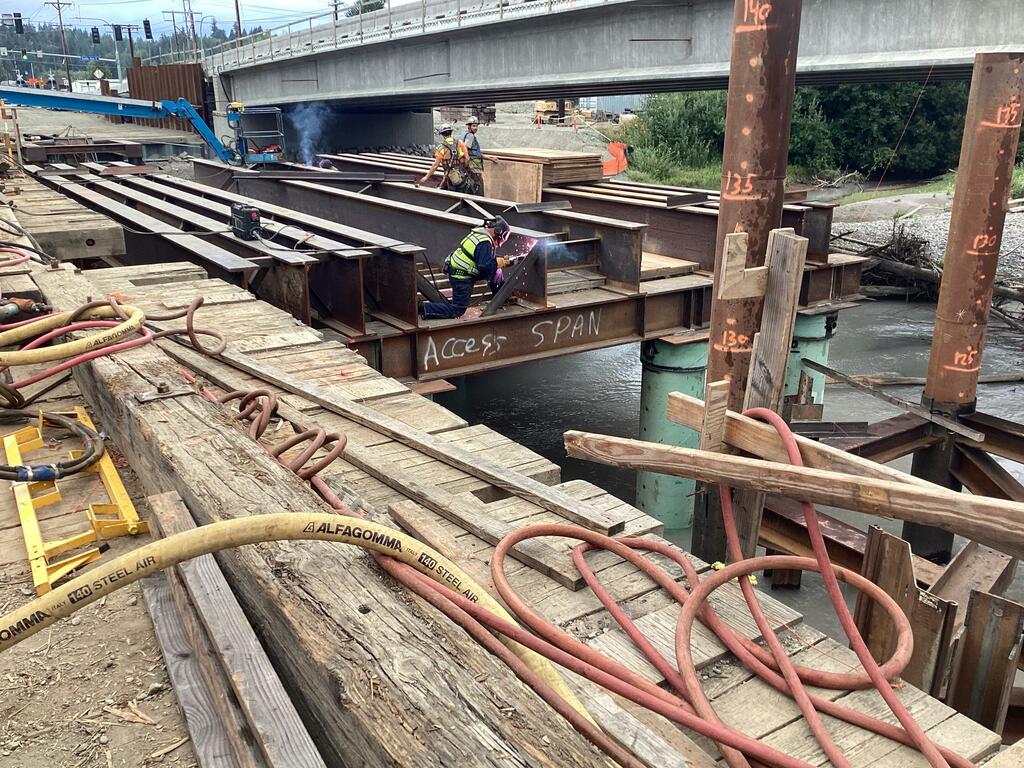

    Bridge Deck Rebar

    New Bridge Looking East

    Height Difference Between New and Old Bridges

  • 11/14/2025 Construction Update

    • WORK COMPLETED FOR WEEK ENDING 11/15/2025:

      • Started work on bridge deck rebar installation
      • Continued work on bridge deck formwork
      • Continued surcharge settlement period
    • WORK IN PROGRESS NEXT WEEK (11/16/2025 - 11/22/2025):

      • Continue bridge deck rebar installation
      • Continued work on bridge deck formwork
    • UPCOMING WORK THROUGH 11/30/2025:

      • Work will continue on new bridge substructure and bridge deck.
      • Surcharge settlement period will be 3 months

    Bridge deck formwork and rebar

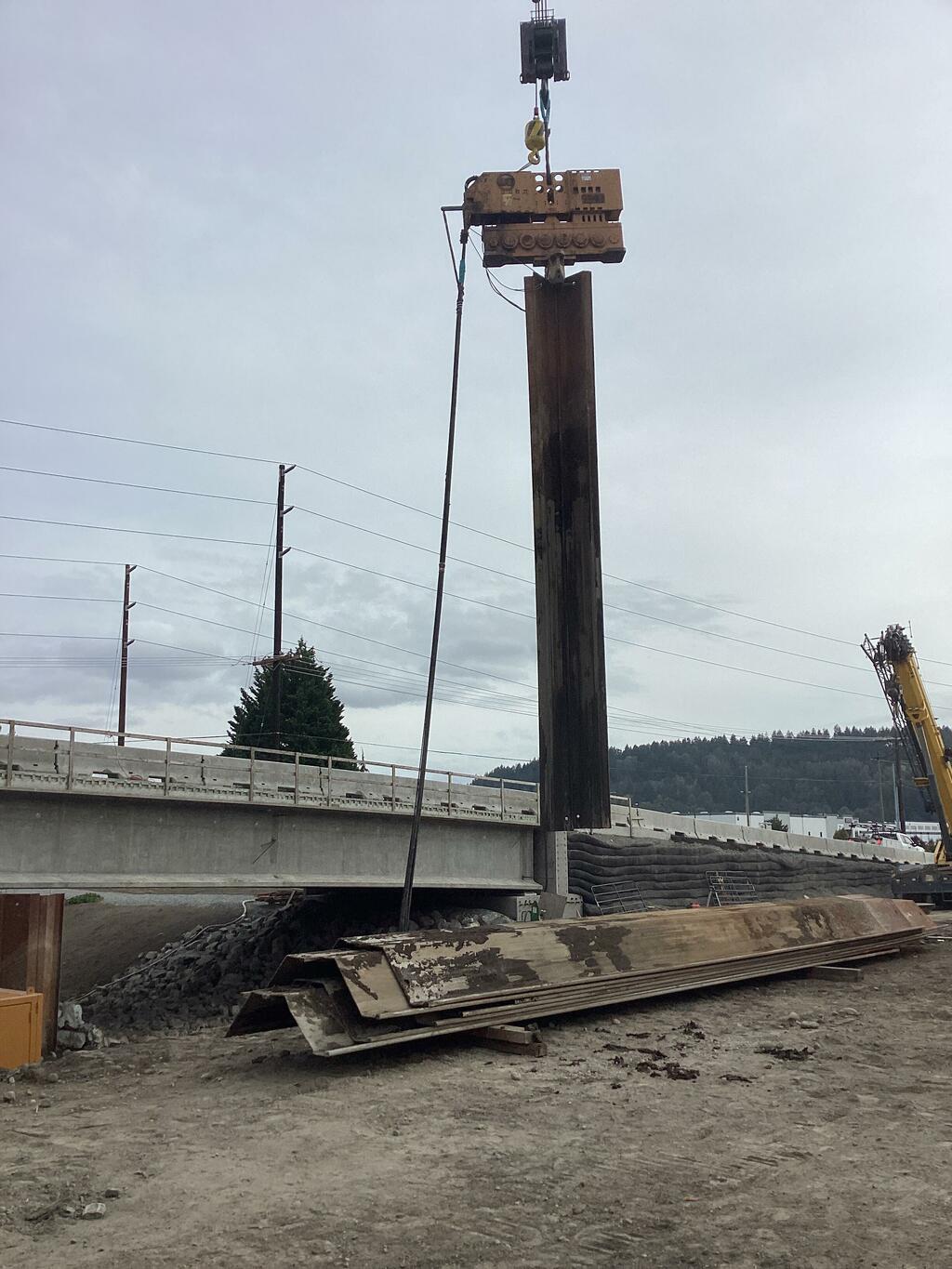

    Staging water line for future under bridge hanging

  • 11/07/2025 Construction Update

    • WORK COMPLETED FOR WEEK ENDING 11/08/2025:

      • Removed diaphragm formwork
      • Continued work on bridge deck formwork
      • Continued surcharge settlement period
    • WORK IN PROGRESS NEXT WEEK (11/09/2025 - 11/08/2025):

      • Begin bridge deck rebar installation
      • Continued work on bridge deck formwork
    • UPCOMING WORK THROUGH 11/30/2025:

      • Work will continue on new bridge substructure and bridge deck.
      • Surcharge settlement period will be 3 months
  • 10/31/2025 Construction Update

    • WORK COMPLETED FOR WEEK ENDING 11/01/2025:

      • Poured bridge diaphragms
      • Worked on temporary walls and permanent walls at bridge approaches
      • Completed surcharge placement
    • WORK IN PROGRESS NEXT WEEK (11/02/2025 - 11/08/2025):

      • Remove diaphragm formwork
      • Begin work on bridge deck formwork
    • UPCOMING WORK THROUGH 11/30/2025:

      • Work will continue on new bridge substructure and bridge deck.
      • Surcharge settlement period will be 3 months

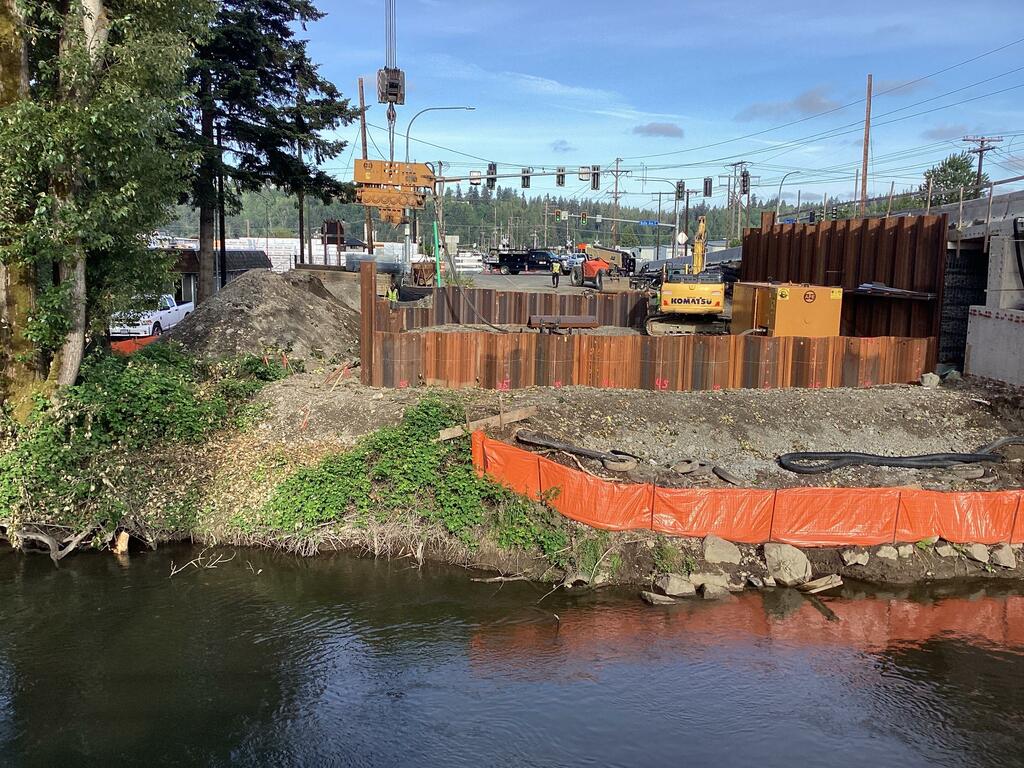

    Temporary Wall and Surcharge Area

    Wall Work

  • 10/24/2025 Construction Update

    • WORK COMPLETED FOR WEEK ENDING 10/25/2025:

      • Began installation of temporary access and false deck on girders
      • Worked on temporary walls and permanent walls at bridge approaches
      • Installed rebar for bridge diaphragms
    • WORK IN PROGRESS NEXT WEEK (10/26/2025 - 11/01/2025):

      • Continue to place surcharge at east and west approaches
      • Continue to work on temporary walls and permanent walls at bridge approaches
      • Pour last bridge diaphragm
    • UPCOMING WORK THROUGH 11/30/2025:

      • Work will continue on new bridge substructure and bridge deck.
      • Surcharge settlement period will be 3 months

  • 10/17/2025 Construction Update

    • WORK COMPLETED FOR WEEK ENDING 10/18/2025:

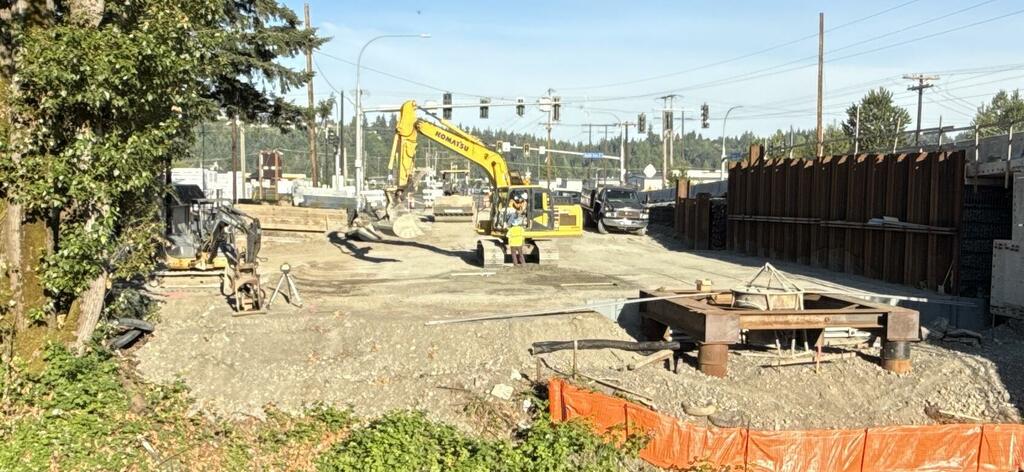

      • Working on fill slopes and grading
      • Started work on temporary walls and permanent walls at bridge approaches
      • -Started installing rebar for bridge diaphragms
    • WORK IN PROGRESS NEXT WEEK (10/19/2025 - 10/25/2025):

      • Continue to fill and grade at bridge approaches
      • Continue to work on temporary walls and permanent walls at bridge approaches
      • Pour bridge diaphragms
    • UPCOMING WORK THROUGH 10/31/2025:

      • Work will continue on new bridge substructure and bridge deck.

  • 10/10/2025 Construction Update

    • WORK COMPLETED FOR WEEK ENDING 10/11/2025:

      • Installed girders for span 1 and 2
      • Completed levee work
    • WORK IN PROGRESS NEXT WEEK (10/12/2025 - 10/18/2025):

      • Start formwork around girder spans 1 & 2
      • Continue to build up bridge approaches
    • UPCOMING WORK THROUGH 10/31/2025:

      • Work will continue on new bridge substructure and bridge deck.

    Girder #1 on span 1

    Girder 2 on Span 1

  • 10/03/2025 Construction Update

    • WORK COMPLETED FOR WEEK ENDING 10/04/2025:

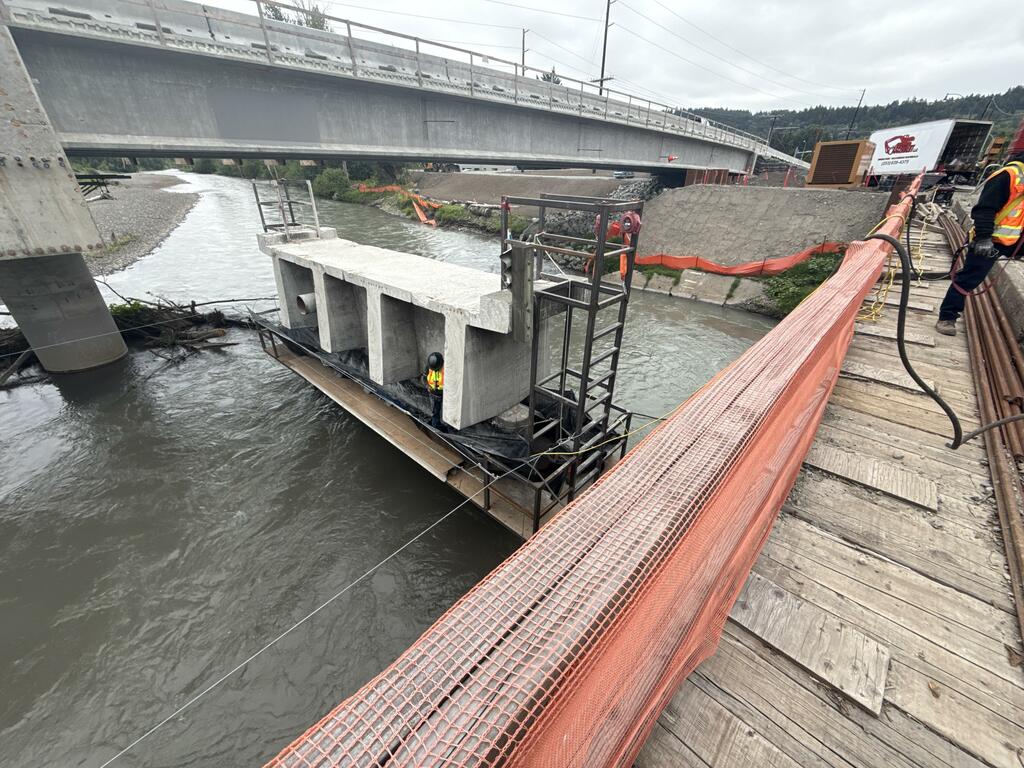

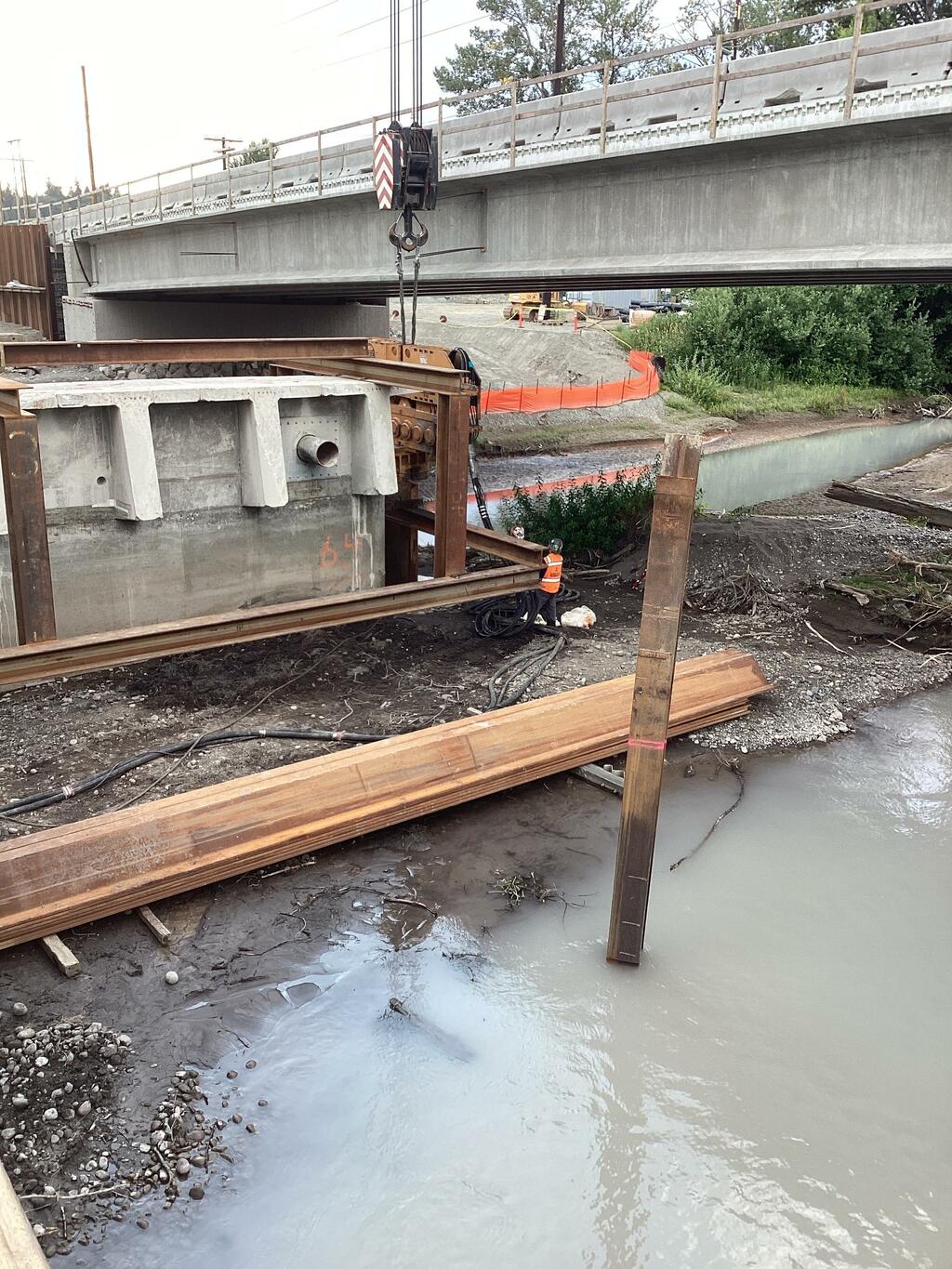

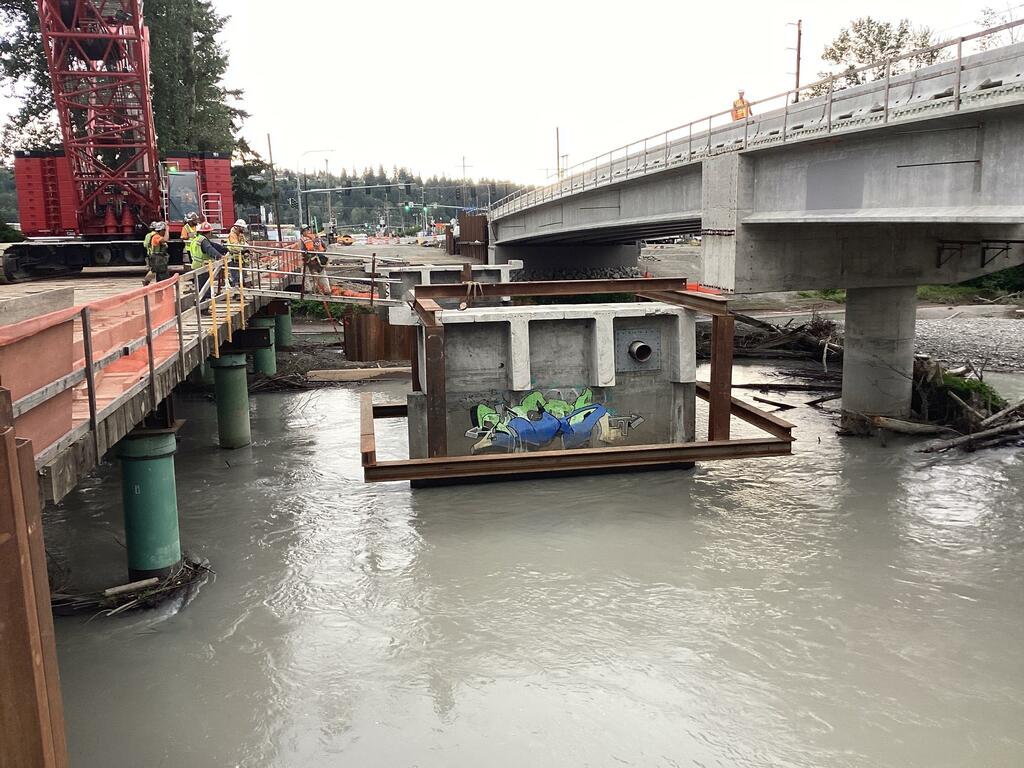

      • Complete pier caps and back walls
      • Completed girder grout pads
    • WORK IN PROGRESS NEXT WEEK (10/05/2025 - 10/11/2025):

      • Girder delivery and placement for spans 1 & 2
      • Install temporary bag retaining wall and build up bridge approaches
      • Continue levee work
    • UPCOMING WORK THROUGH 10/31/2025:

      • Girder delivery and installation will be on the nights of 10/09/25 & 10/10/25. There will be a full closure of Stewart road during this time. The closure will be on the night of 10/09/25 from 8pm to 5am and the night of 10/10/25 from 8pm to 6am. Detour routes will be provided. Please see overview map of detour route below.

  • 09/26/2025 Construction Update

    • WORK COMPLETED FOR WEEK ENDING 09/27/2025:

      • Complete pier caps and back walls

      • Started levee work
      • Removed all northern access from the river
      • Started work on bag wall
    • WORK IN PROGRESS NEXT WEEK (09/28/2025 - 10/04/2025):

      • Complete levee work
      • Complete girder grout pads
      • Install temporary bag retaining wall and build up bridge approaches
    • UPCOMING WORK THROUGH 10/31/2025:

      • Girder delivery and installation will be on the nights of 10/09/25 & 10/10/25. There will be a full closure of Stewart road during this time. The closure will be from 8pm to 6am both nights. Detour routes will be provided.
      • Brief traffic interruptions will occur during crane operations. Traffic impacts expected to be minimal.

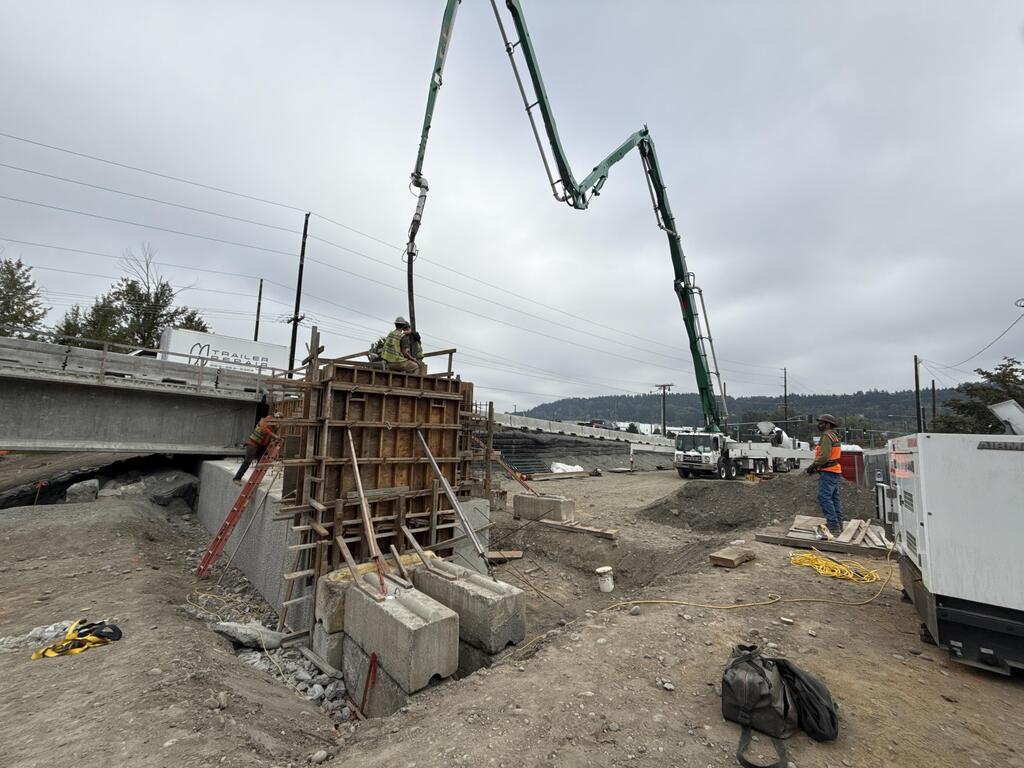

    Pier 3 Cap Formwork

    Pier 3 Cap and back wall

Page last updated: 05 Dec 2025, 10:54 AM
