08/15/2025 Construction Update
-
WORK COMPLETED FOR WEEK ENDING 08/16/2025:

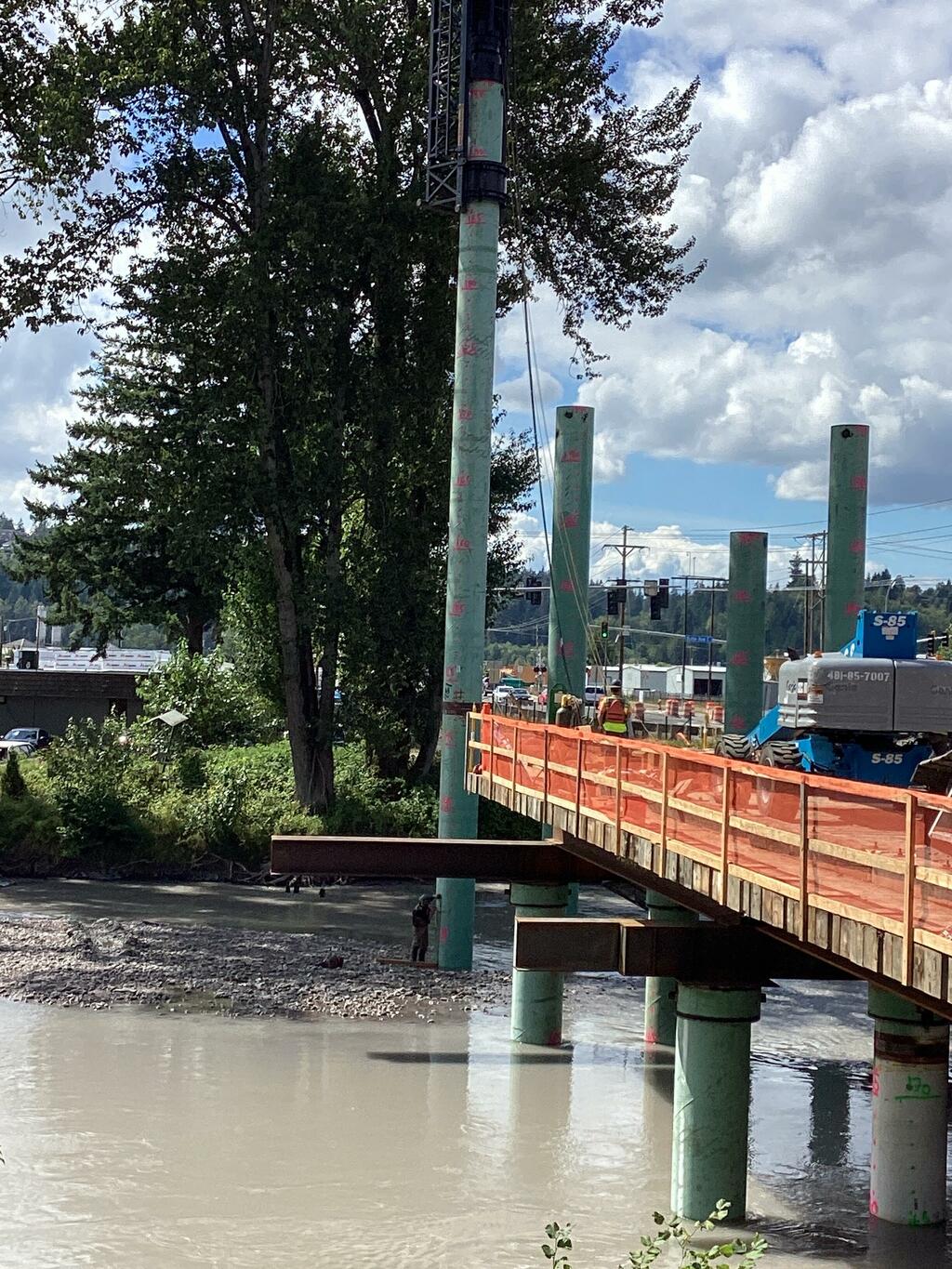

- Complete driving 36" pile for southern trestle access
- Complete driving sheet pile at northern trestle access
- Install reaction frame for drilling permanent bridge shafts at pier 3
- Excavated pier 1 shaft
- Install shaft 1 rebar
-
WORK IN PROGRESS NEXT WEEK (08/17/2025 - 08/23/2025):
- Complete testing of constructed pier 2
- Remove Reaction Frame and Northern Access
- Install Pier 3 cap formwork and pour
- Pour pier 1 shaft
-
UPCOMING WORK THROUGH 09/30/2025:
- In-water work will commence until end of fish window.
- Brief traffic interruptions will occur during crane operations. Traffic impacts expected to be minimal.
Installing Shaft 2 Casing
