07/18/2025 Construction Update
WORK COMPLETED FOR WEEK ENDING 07/18/2025:
*In-water work fish window begins this week*

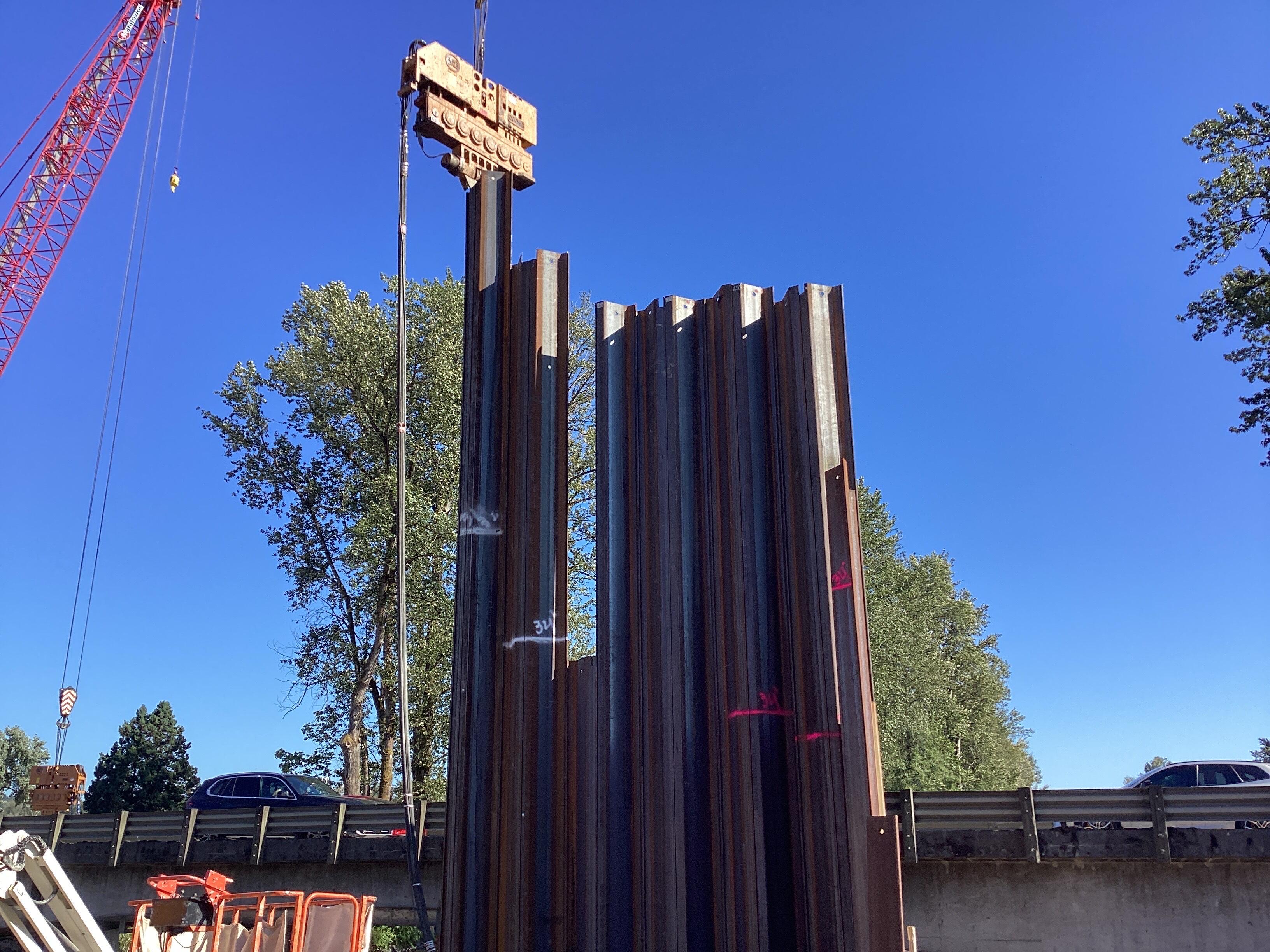

- Drive temporary sheet piles at north side trestle access

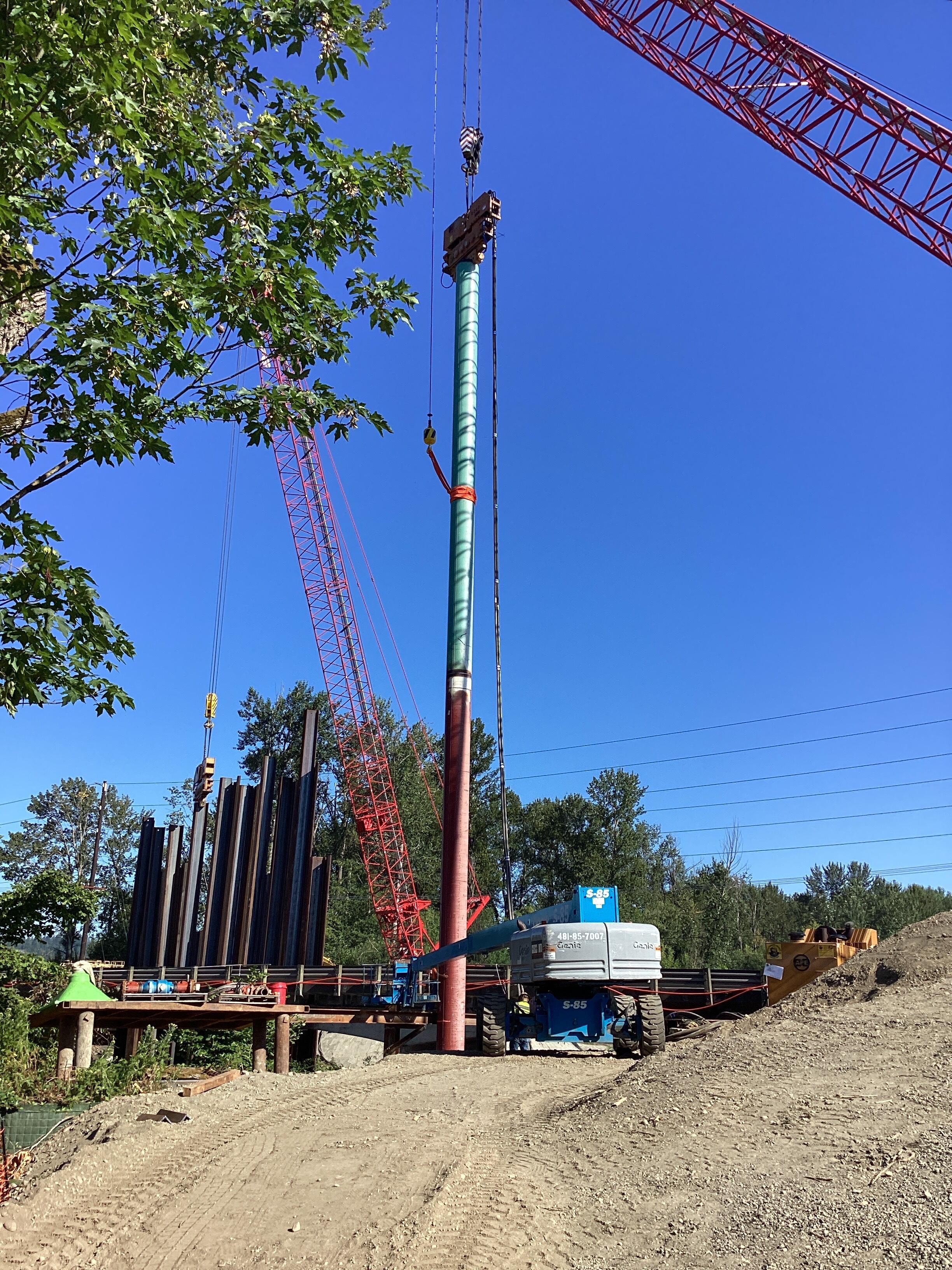

- Drive temporary 36" pipe pile at the south trestle access
- Removed revetment panels on east river bank
-
WORK IN PROGRESS NEXT WEEK (07/21/2025 - 07/25/2025):
- Continue driving 36" pile for southern trestle access
- Continue driving sheet pile at northern trestle access
- Backfill northern trestle access for pier 2
- Install reaction frame for drilling permanent bridge shafts at pier 2
- Make dewatering connections
- Begin drilling pier 3 shaft
-
UPCOMING WORK THROUGH 09/30/2025:
- In-water work will commence until end of fish window.
- Brief traffic interruptions will occur during crane operations. Traffic impacts expected to be minimal.
